S-100 Mechanical Unit Replacement
Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| 01-2026 | 05-29-2026 | 01-29-2027 | N/A |
Current Status/Phase: Design Phase
Project Insights
As of May 26, 2026, the DSA resubmittal was completed and the DSA review is due on May 29, 2026. If necessary, an over-the-counter review will be conducted in mid-June.
Upcoming Milestones:

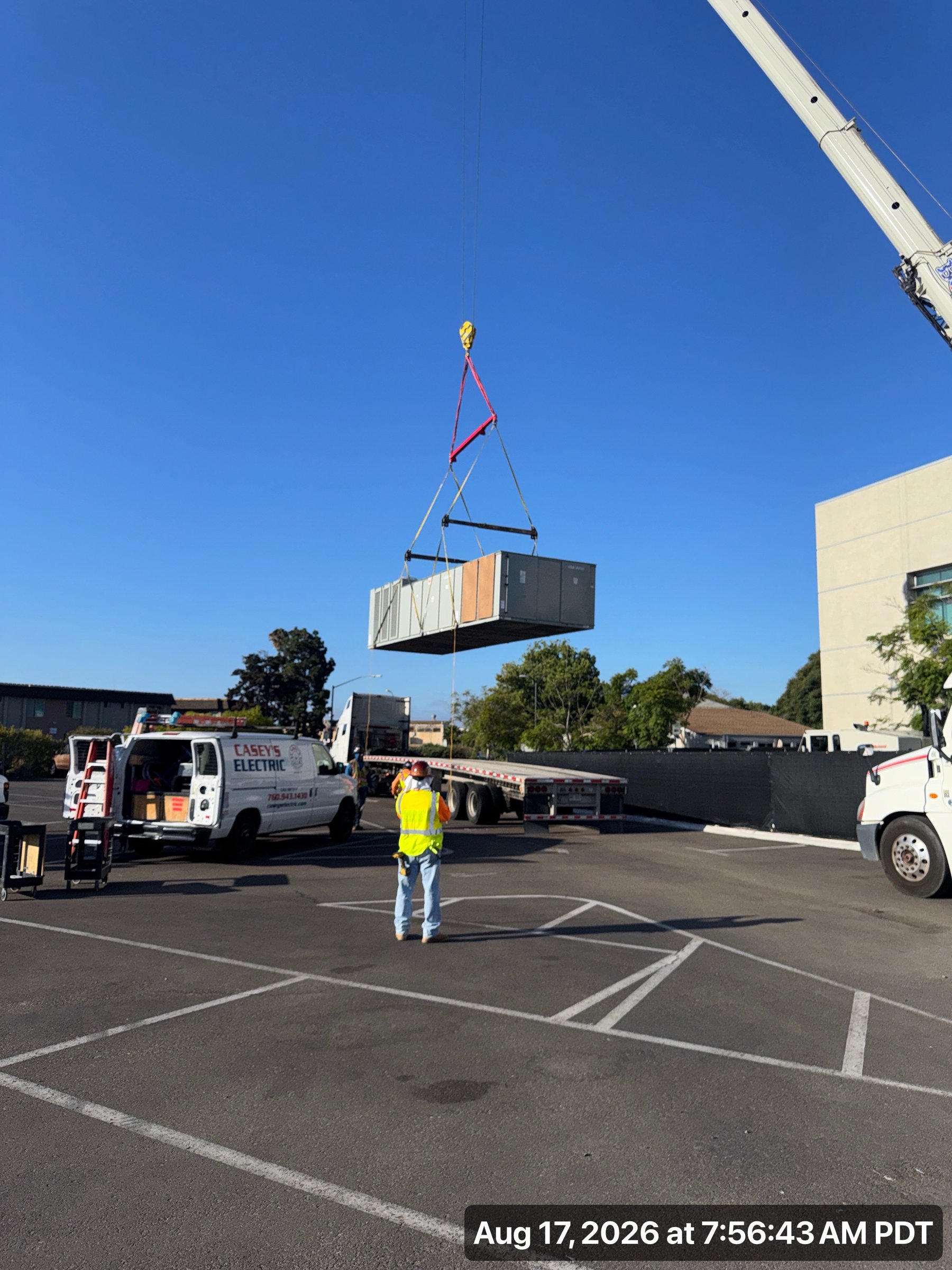

- Bid schedule reflects staggered installations on August 7 and August 21, 2026, with remaining equipment including boilers, Exhaust Fans (EFs), and Fan Coils (FCs) scheduled for installation during the January 2027 intersession.
Project Features

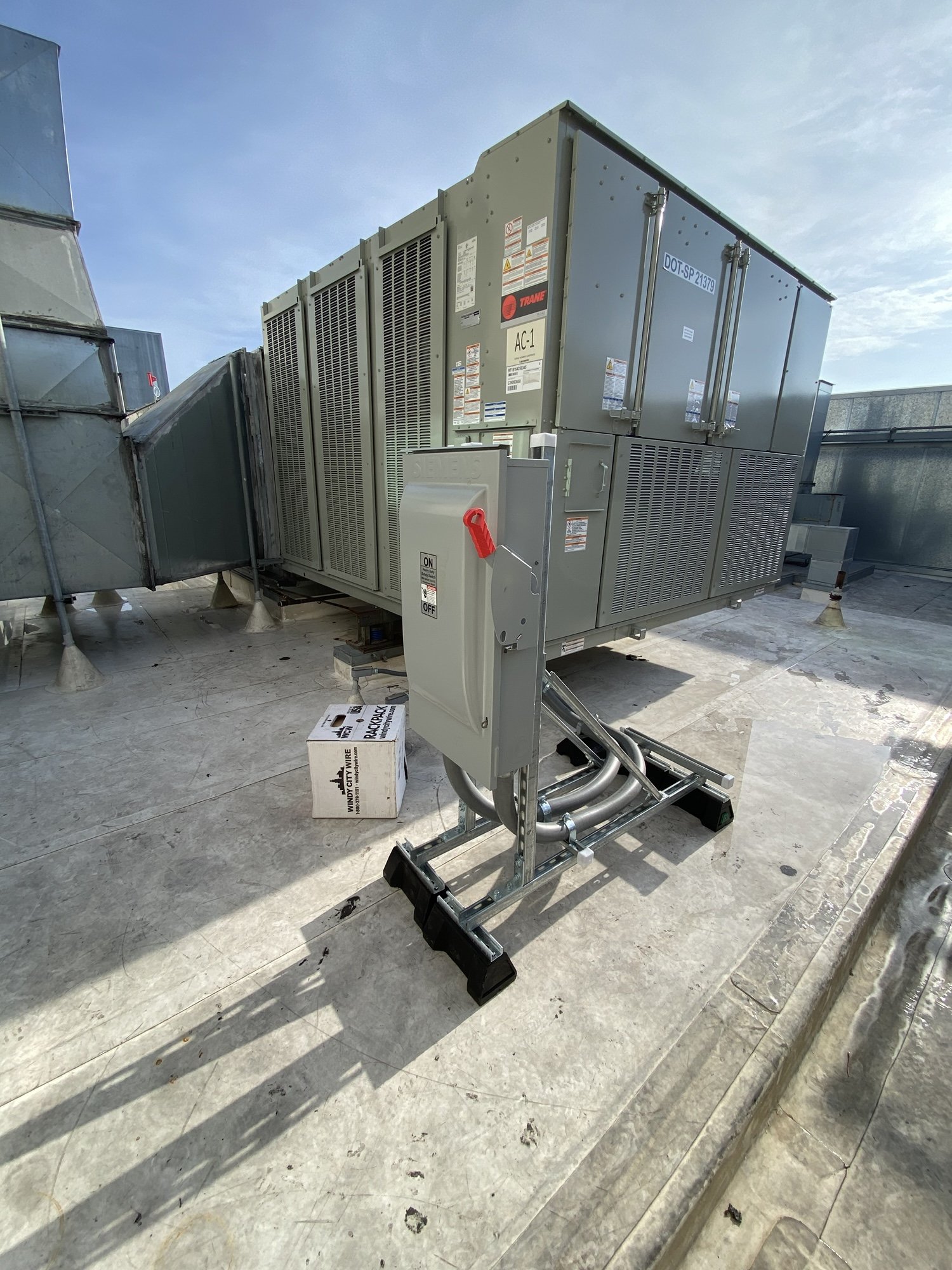

- Replacement of three air handling units on existing roof
- Replacement of three split system fan coil units on existing roof and inside existing IT rooms
- Replacement of three exhaust fans on existing roof
- Replacement of boiler and addition of redundant boiler on existing roof
- Replacement of two pumps on existing roof

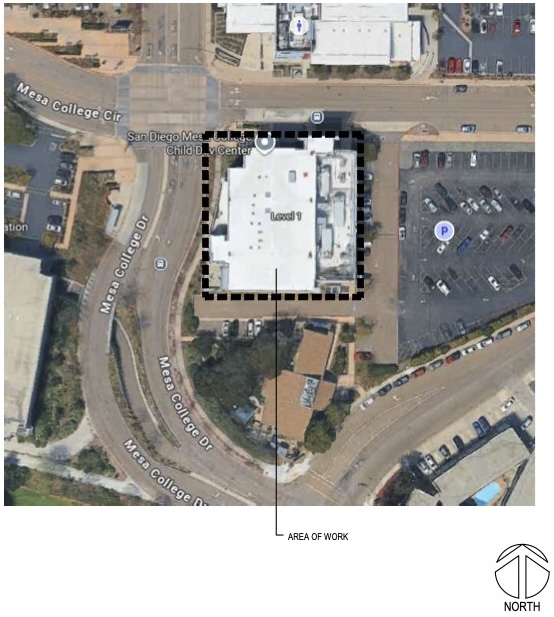

Project Map

7250 Mesa College Dr, San Diego, CA 92111

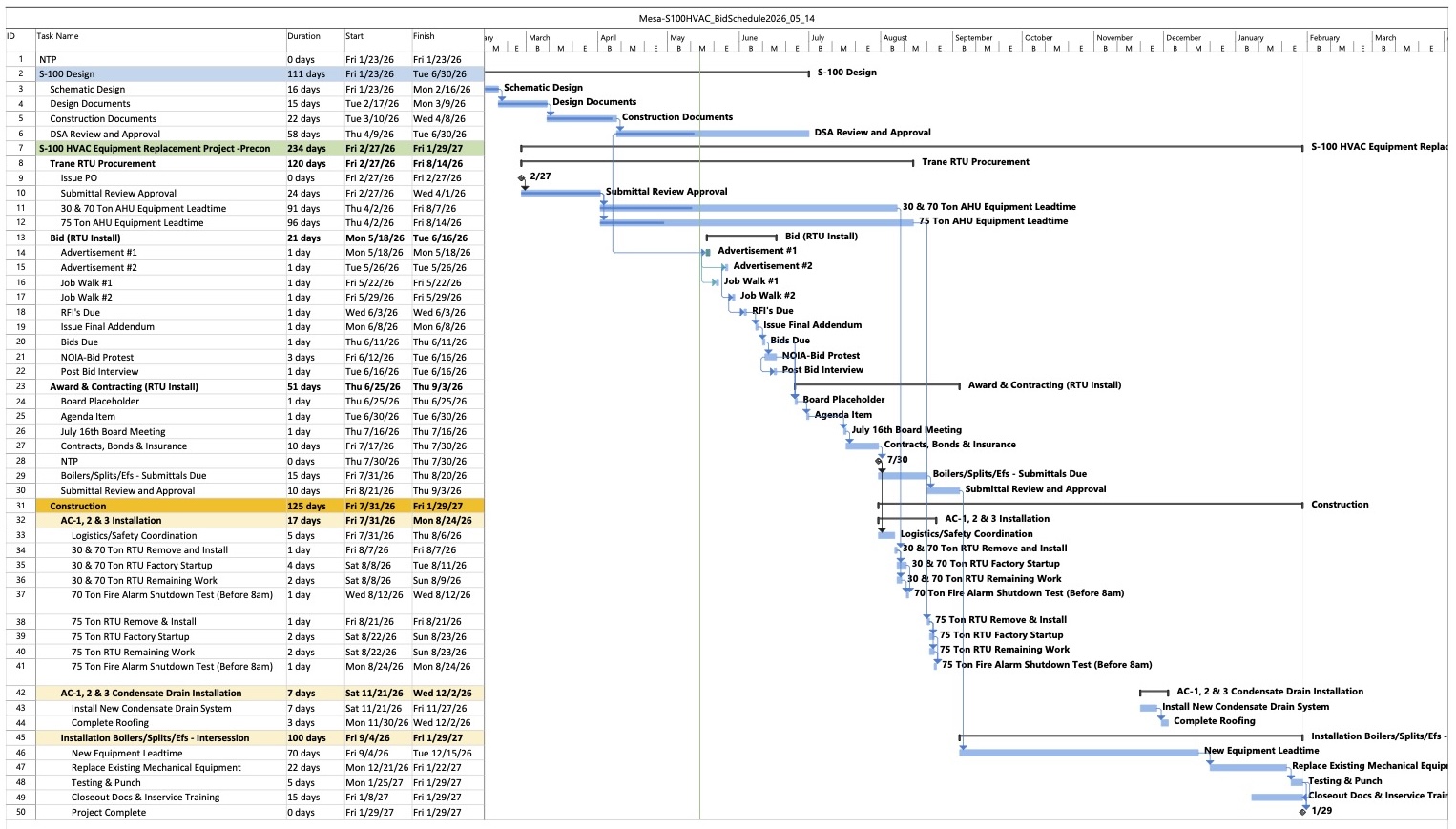

Project Schedule

Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.
Project Teams
| General Contractor | TBD |
| Architect | N/A |
| Structural Engineer | N/A |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | H + W Engineering |
| Executive Const. Manager | Jonathan Cruz |
Last updated: June 1, 2026
